32

January 2020

solution proposed and based on site specific metocean

conditions. The hydrodynamic performance of the system

is confirmed by advanced hydrodynamic models and,

combined with historical metocean data, this predicts the

corresponding uptime at the site. This ensures that the

final design is capable of operating safely and can handle

survival conditions with an associated mooring system.

The goal of this feasibility study is to generate

infrastructure alternatives in order to identify the solution

which offers flexibility to LNG demand, minimal impact to

existing infrastructure, for lowest investment. One of the

existing jetties is deemed as the most appropriate to

modify and accommodate the UTS interface with onshore

piping. The recommended solution is to branch an LNG

line off one of the existing jetties, supported by piles to

the UTS tie-in point. The floating cryogenic flexible pipes

are tied into the rigid pipe above the water and guided

into the water from a simple chute construction. The large

tidal differences at the location is a challenge for a fixed

structure interface to a vessel, so a floating transfer

system like the UTS, which follows the LNG carrier

vertically with the tide, is technically and operationally

advantageous. The transfer system can easily be stored

alongside an existing decommissioned jetty while not in

use.

Case B – small scale LNG for

bunkering

In Case B, both a traditional jetty and a jettyless

alternative are being considered. The aim of this

feasibility study is to generate CAPEX estimates for both

solutions, in addition to analysing how the UTS will

perform from an operational perspective.

Three different locations are analysed, together with

site specific metocean conditions. Consideration is given

to wind and wave conditions, water depth, marine traffic,

operational frequency in the area, tie-in infrastructure

onshore and optimisation of the floating cryogenic hose

length, for both the operation and idle modes of the UTS.

The different locations are weighted in order to conclude

on the optimal mooring location. In general, Case B’s

location shows challenging metocean data, so specific

numerical models are created in order to simulate

resultant hydrodynamic effect on the UTS motion and

mooring system, including the vacuum mooring system

from the UTS to the LNG carrier, for different wave

heights, winds speeds and wave directions. The total

uptime of Case B is dominated by the wave conditions for

the jettyless UTS and is found to be 94%, while the

proposed jetty structure has 92% uptime.

The LNG bunkering market has a sense of urgency due

to the IMO 2020 sulfur cap, so bunkering capabilities along

and around major shipping routes are necessary. In this

Case B, the schedule to build and install a transfer solution

can be considerably compressed, with a UTS lead time of

12 months versus new jetty construction of 36 – 40 months.

The resultant UTS design is well within the design

parameters of the existing UTS unit,

La Santa Maria

.

Consequentially, cost optimisation through product

standardisation ensures a more competitive solution to a

bespoke jetty structure. The study concludes that CAPEX

savings are in the order of 60% for the UTS versus a

traditional jetty.

Conclusions

z

The relative price of small scale LNG compared with

competing fuels is a key factor in determining its

demand in the future, especially in developing and

remote areas.

z

Collaboration across geopolitical boundaries is

required. Proactive participation from regional

stakeholders on policies, regulations and permits will

simplify and incubate innovation and investment.

z

Small scale LNG Infrastructure needs to modularised.

Bespoke civil works with specialised labour force is

costly and time-consuming. Standard plug-and-play

solutions will reduce the CAPEX burden, as well as

minimising project execution risk, cost and schedule

overruns.

z

The two cases illustrated here are common across

the globe. It has been proven that jettyless versus

traditional jetty construction answers the global

climate challenge.

z

In addition to being highly cost-effective and

providing significant schedule reductions, the floating

UTS is easily transportable to solve the next energy

challenge, thus answering the needs of spot markets

and fluctuation in energy needs.

Innovation highlight: UTS

vacuummooring system

The UTS’s mooring system is a vacuum-based automated

mooring technology that safely holds even the largest

450 000 DWT bulk vessels and Super Post-Panamax

container vessels. It eliminates the need for conventional

mooring lines. Remote controlled vacuum pads attached

to hydraulic actuated arms extend, attach and moor ships

in a few seconds.

Such systems have successfully completed more than

500 000 automated mooring operations and, by 2020,

approximately 500 000 such operations will be made

annually.

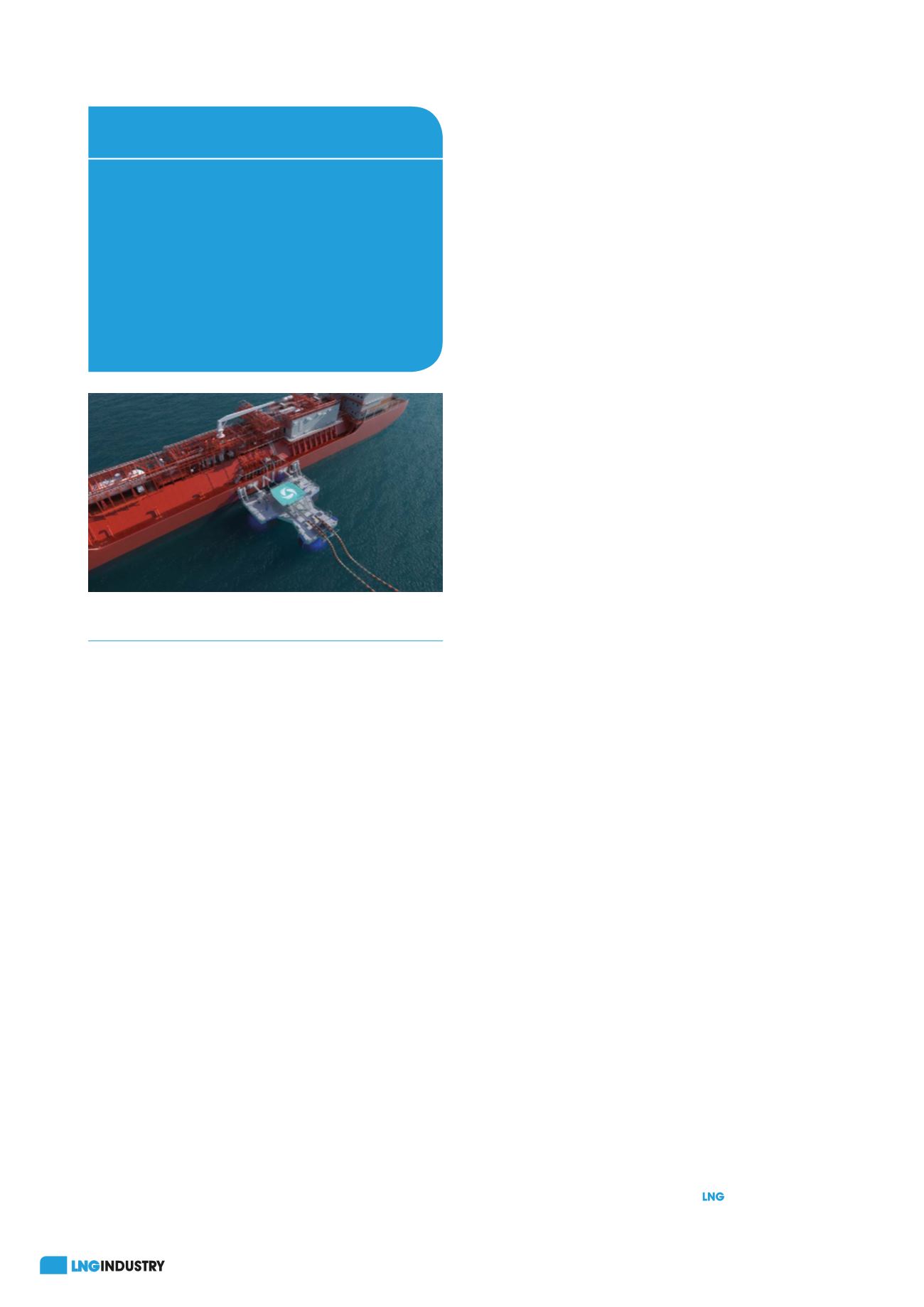

Figure 4.

Simple and field proven vacuum attachment
